Cliff Avenue and I229 Interchange

  • Project value$49,915,020
  • Contractor nameT&R Contracting, inc.
  • Completion DateJune 25, 2027

Cliff Avenue I229 Aerial Diagram

Cliff Ave I229 Aerial Diagram

Project Update: 06/01/2026

  • The grading contractor will continue work on the west half of the northbound Interstate 229.

  • The retaining wall contractor plans to construct a 650-foot mechanically stabilized earth (MSE) retaining wall along the south side of the northbound on-ramp, followed by a 180-foot MSE wall between the northbound on-ramp and the interstate.

  • Sanitary sewer installation will take place along Cliff Avenue.

  • Bridge crews plan to drive piles and construct both northbound bridge bents.

  • Grading, retaining wall construction, sanitary sewer installation, and bridge work are underway.

Commuter Route Information

  • Beginning on Friday, May 29, 2026, the current two-way traffic configuration on Cliff Avenue between 41st Street and the Spencer Park access road will be switched from the two inside lanes to the two northbound lanes. Once this traffic switch is complete, motorists will no longer be able to make left turns from the southbound Interstate 229 off-ramp onto southbound Cliff Avenue. This will be in effect until later this fall when the new lanes on Cliff Avenue have been constructed.
  • Beginning on Monday, June 8, 2026, Cliff Avenue will be closed south of the existing southbound I-229 ramps to the Spencer Park access road. The closure is anticipated to last one week, weather permitting. The contractor will be installing a sanitary sewer main along Cliff Avenue south of the bridge.

Project Milestones

2025 (Before School Session Ends)

  1. Install traffic control and detours
  2. Shift I-229 southbound traffic to the northbound lanes and bridge, and northbound traffic to the temporary diversion and bridge
  3. Remove the existing southbound bridge
  4. Removals on 41st Street
  5. Removals on Pam Road
  6. Close southbound I-229 off-ramp; southbound I-229 on-ramp
  7. Construction of the southbound I-229 bridge abutments, piers, and grading
  8. Construction of the southbound off-ramp and installation of a pedestrian tunnel
  9. Install sanitary sewer on 41st Street
  10. Install a water main on 41st Street
  11. Install storm sewer on 41st Street

2025 (During/After School Summer Break)

  1. Close Cliff Avenue north of the existing northbound I-229 ramps to 38th Street
  2. Close the Lincoln High School entrance
  3. Install a water main on Cliff Avenue
  4. Install a sanitary sewer on Cliff Avenue
  5. Install a storm sewer on Cliff Avenue
  6. Construct the Lincoln High School entrance and parking lot
  7. Install a permanent traffic signal at 38th Street and Cliff Avenue
  8. Construct the portion of Cliff Avenue north of 41st Street
  9. Install a permanent traffic signal at 41st and Cliff Avenue
  10. Southbound I-229 paving
  11. Construct sidewalks
  12. Construct a bridge and walls
  13. Construct a temporary pedestrian access from the existing sidewalk to the trail under the southbound off-ramp
  14. Remove the temporary bridge (if the weather allows)
  15. Apply winter paving markings on Cliff Avenue

2026

  1. Install traffic control and detours
  2. Shift I-229 traffic to the southbound lanes and the bridge
  3. Remove the northbound I-229 bridge and the temporary bridge (if still in place)
  4. Construction of the northbound I-229
  5. Construction of the new northbound I-229 bridge
  6. Restrict Cliff Avenue to one lane in each direction
  7. Install a sanitary sewer
  8. Install a water main
  9. Install a storm sewer
  10. Construct southbound Cliff Avenue
  11. Construct portions of the northbound off-ramp
  12. Closure of the northbound on-ramp to begin construction of the pedestrian tunnel and retaining wall
  13. Shift Cliff Avenue traffic to southbound lanes (one lane in each direction)
  14. Construct northbound Cliff Avenue
  15. Construct the northbound on-ramp and pedestrian tunnel

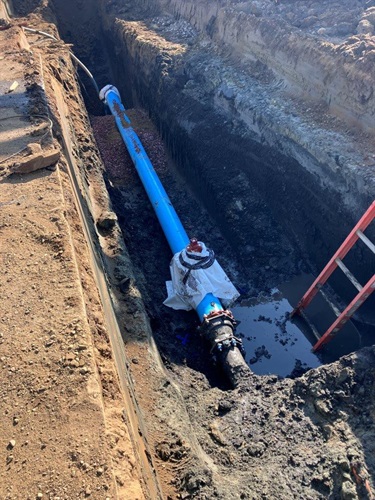

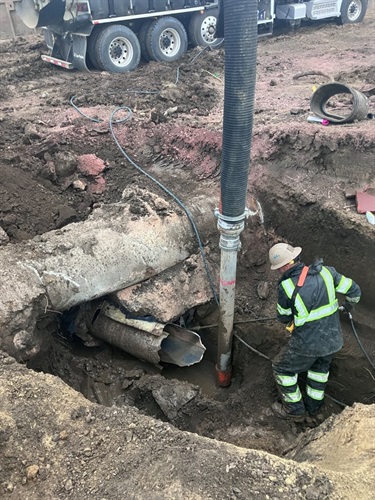

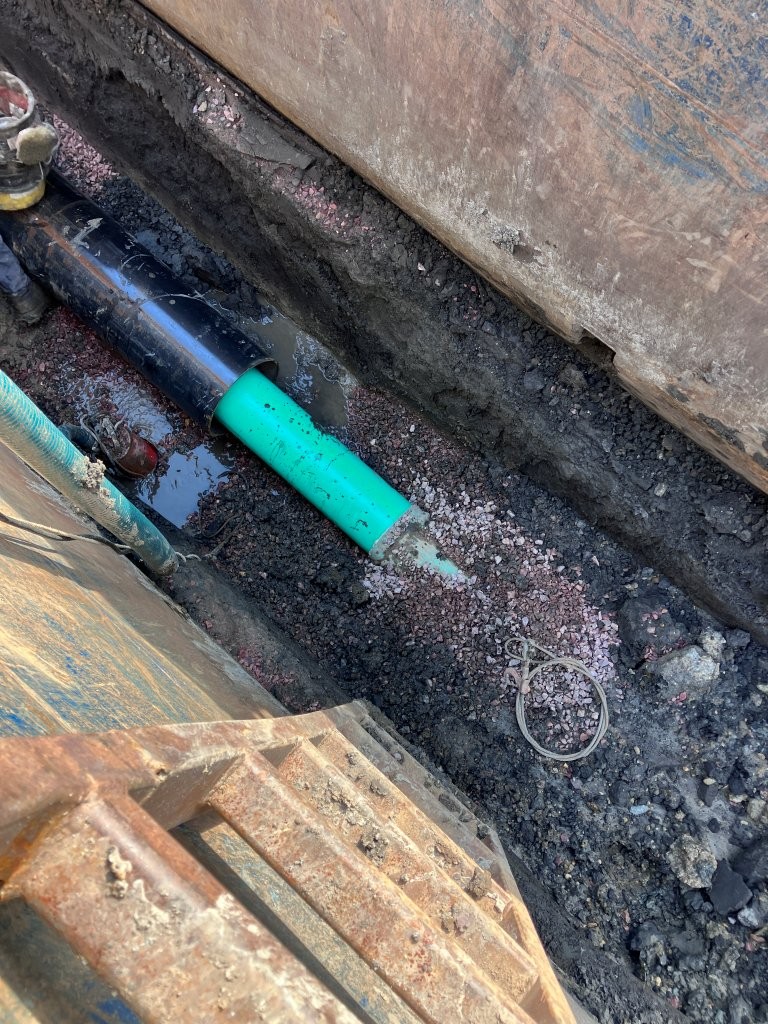

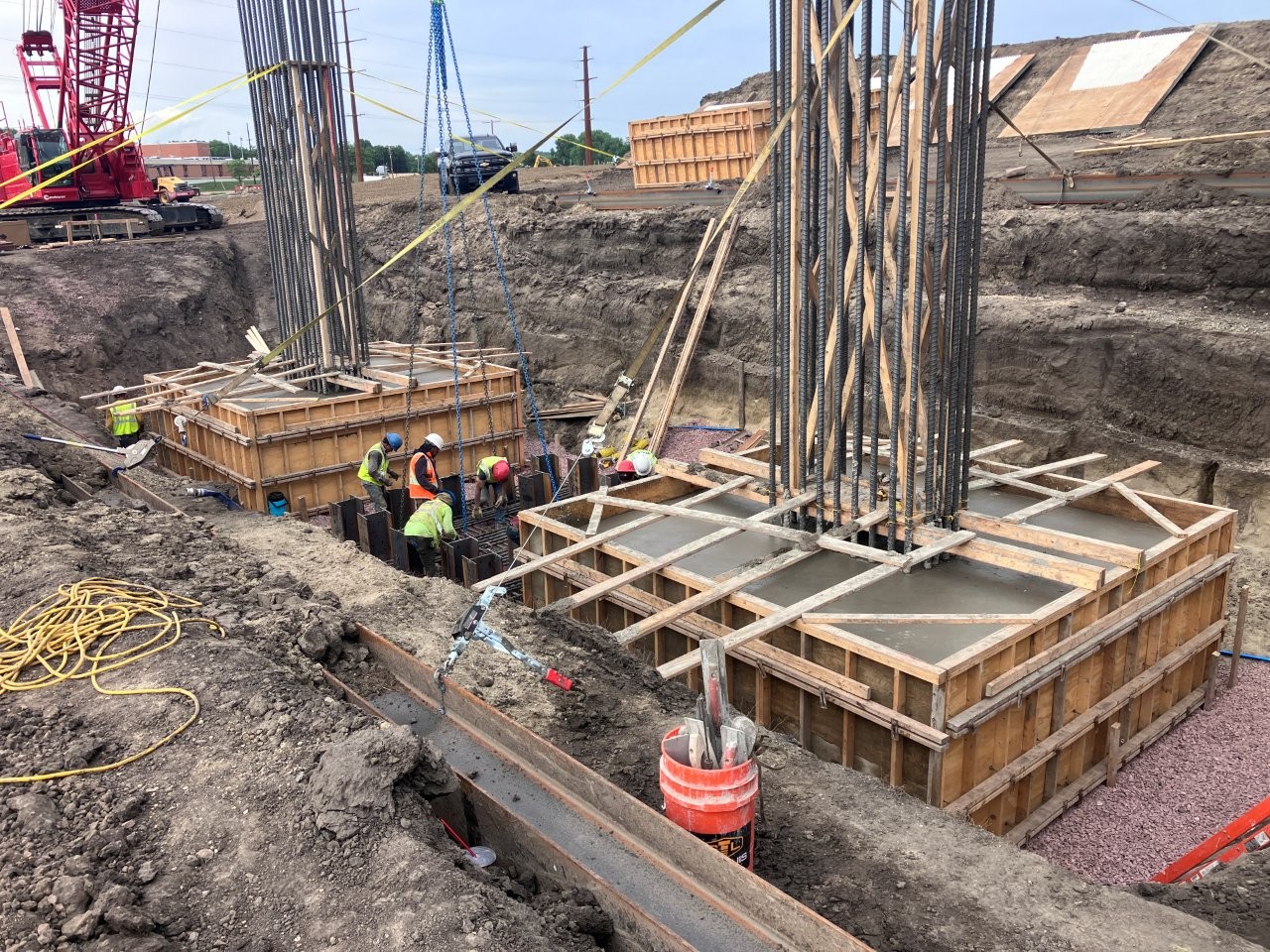

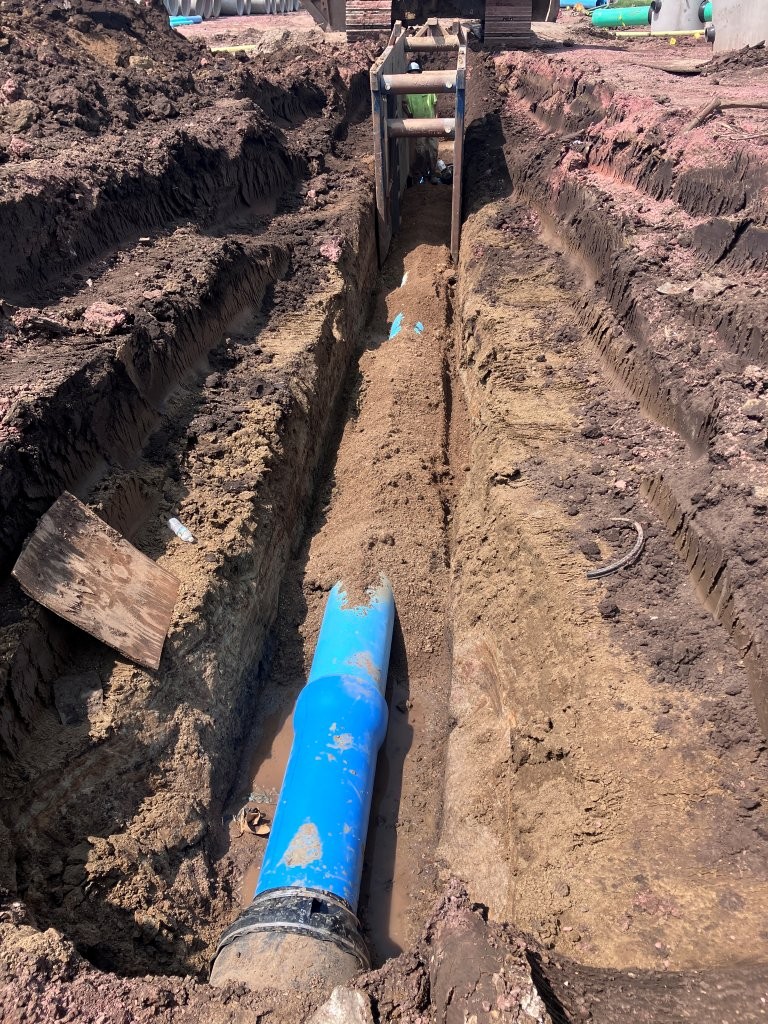

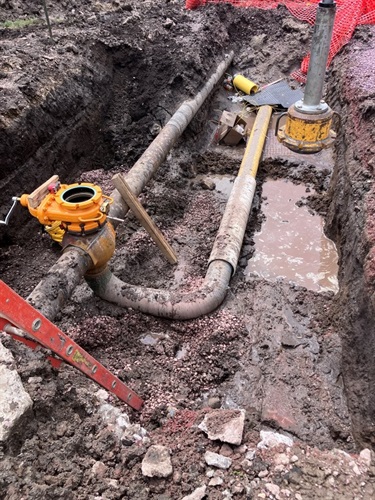

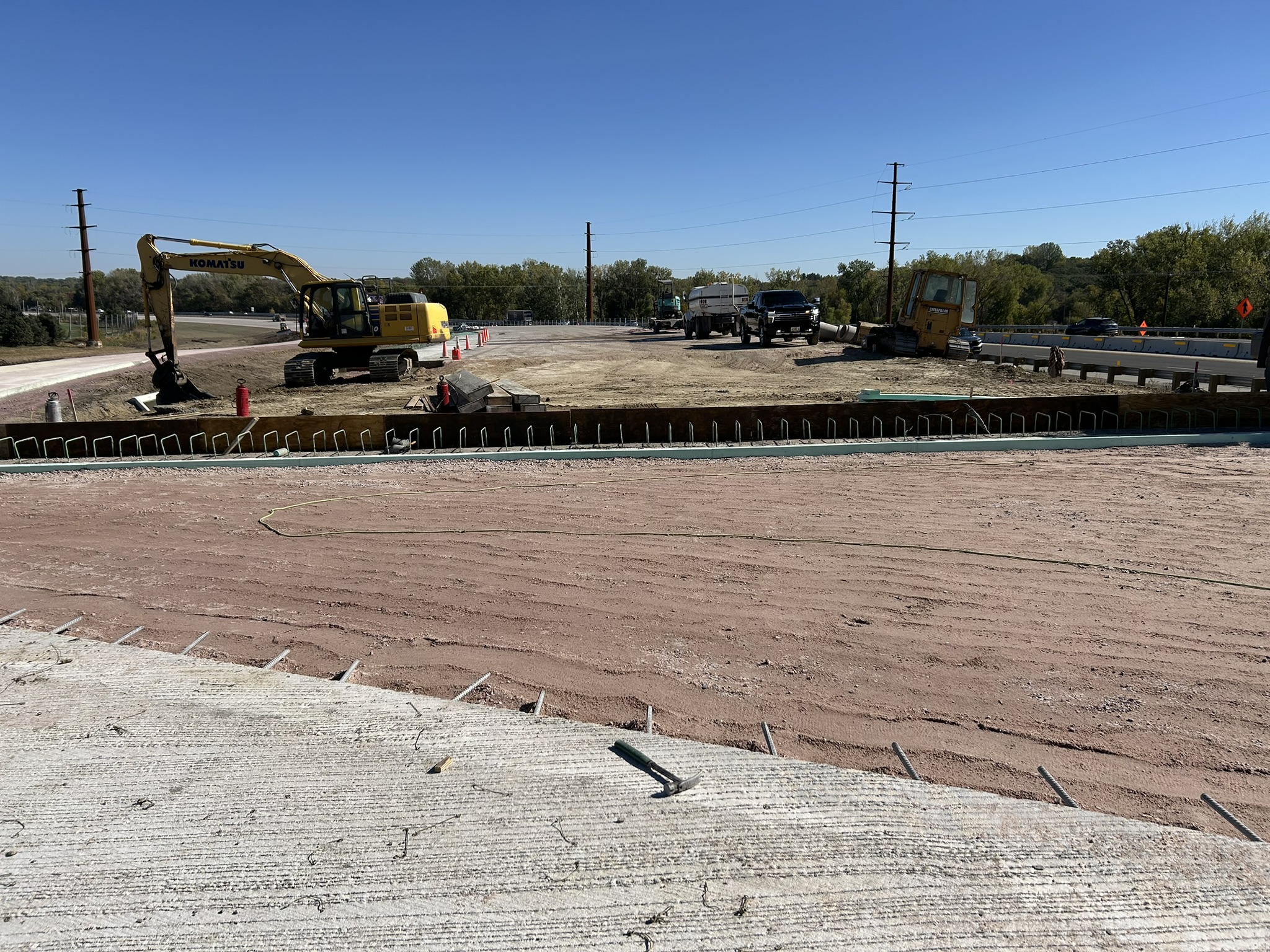

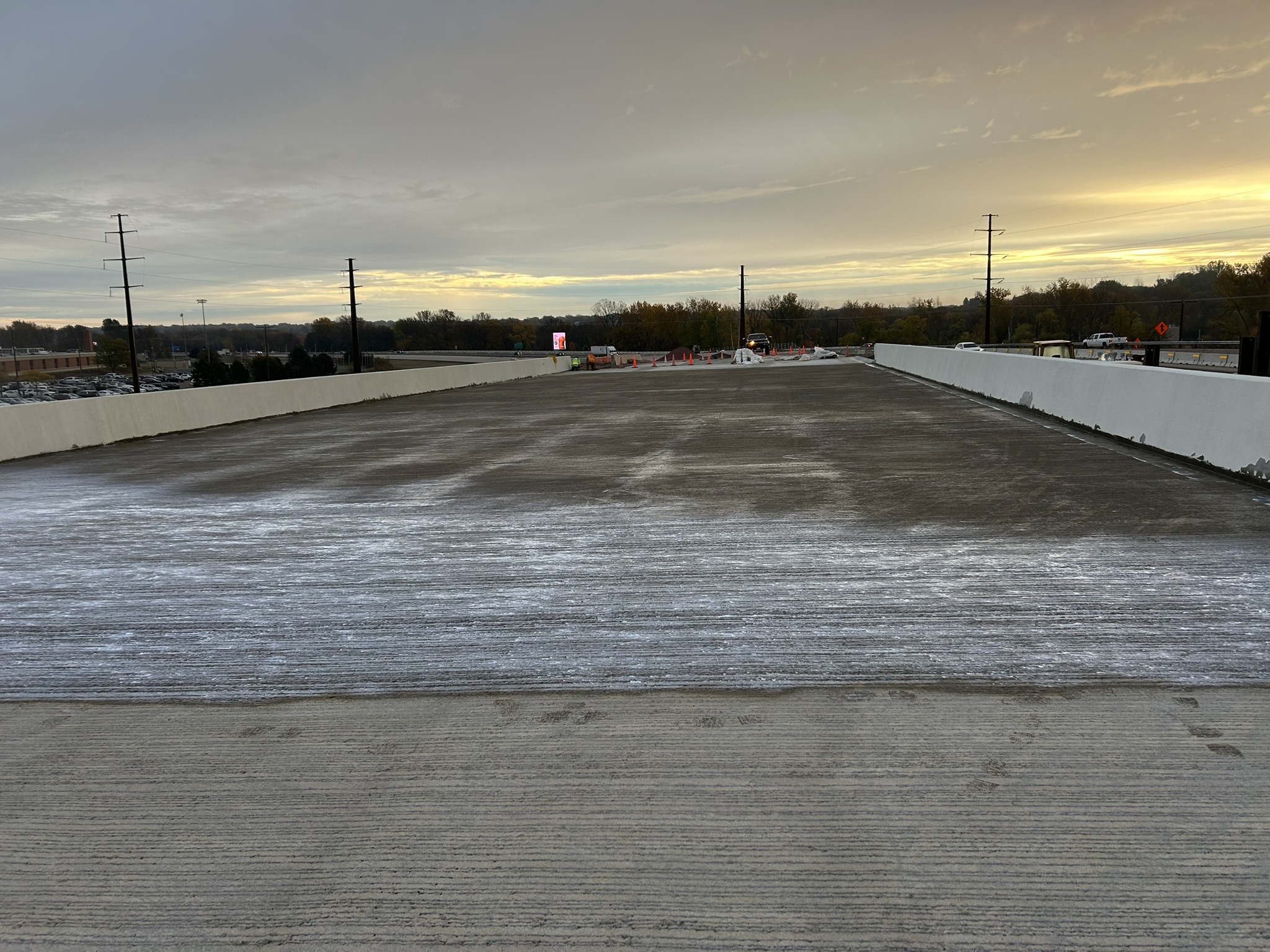

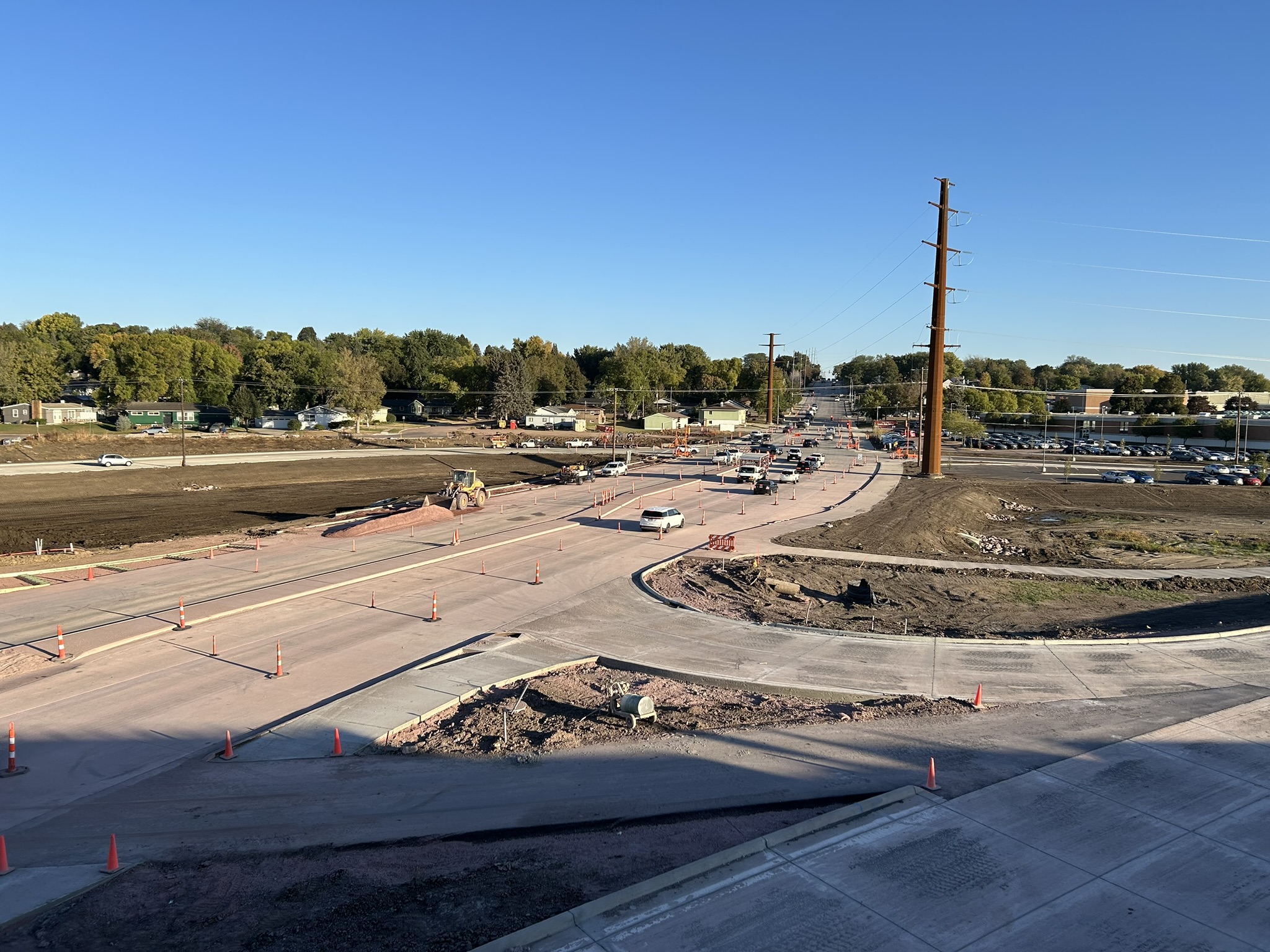

Construction Images
