Benson Road / I-229 Interchange Reconstruction

  • Project value$36,360,596.00
  • Contractor nameT&R Contracting, Inc.
  • Completion DateJune 27, 2025
benson-webpage-banner

Project Update 6/28/2024

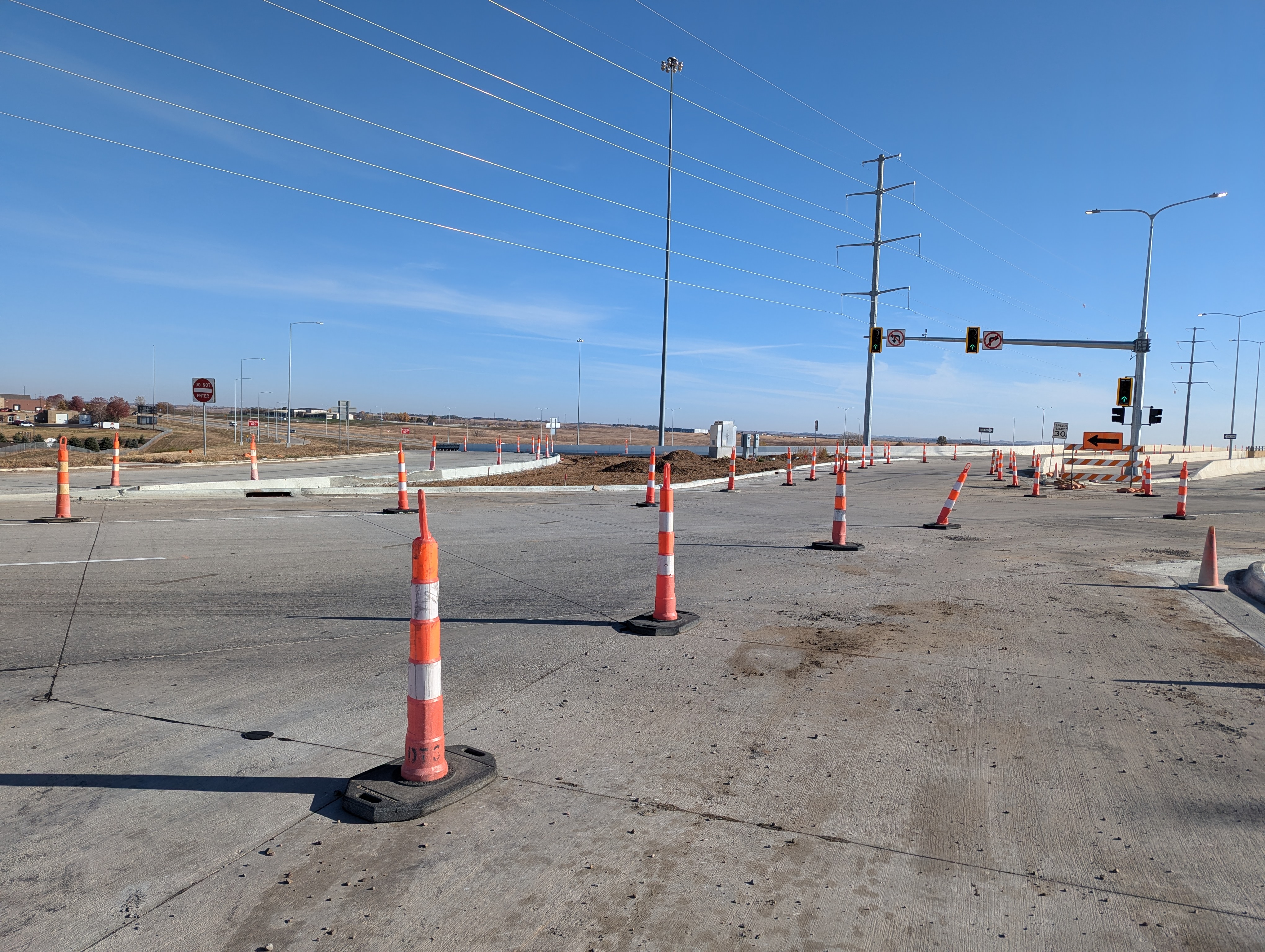

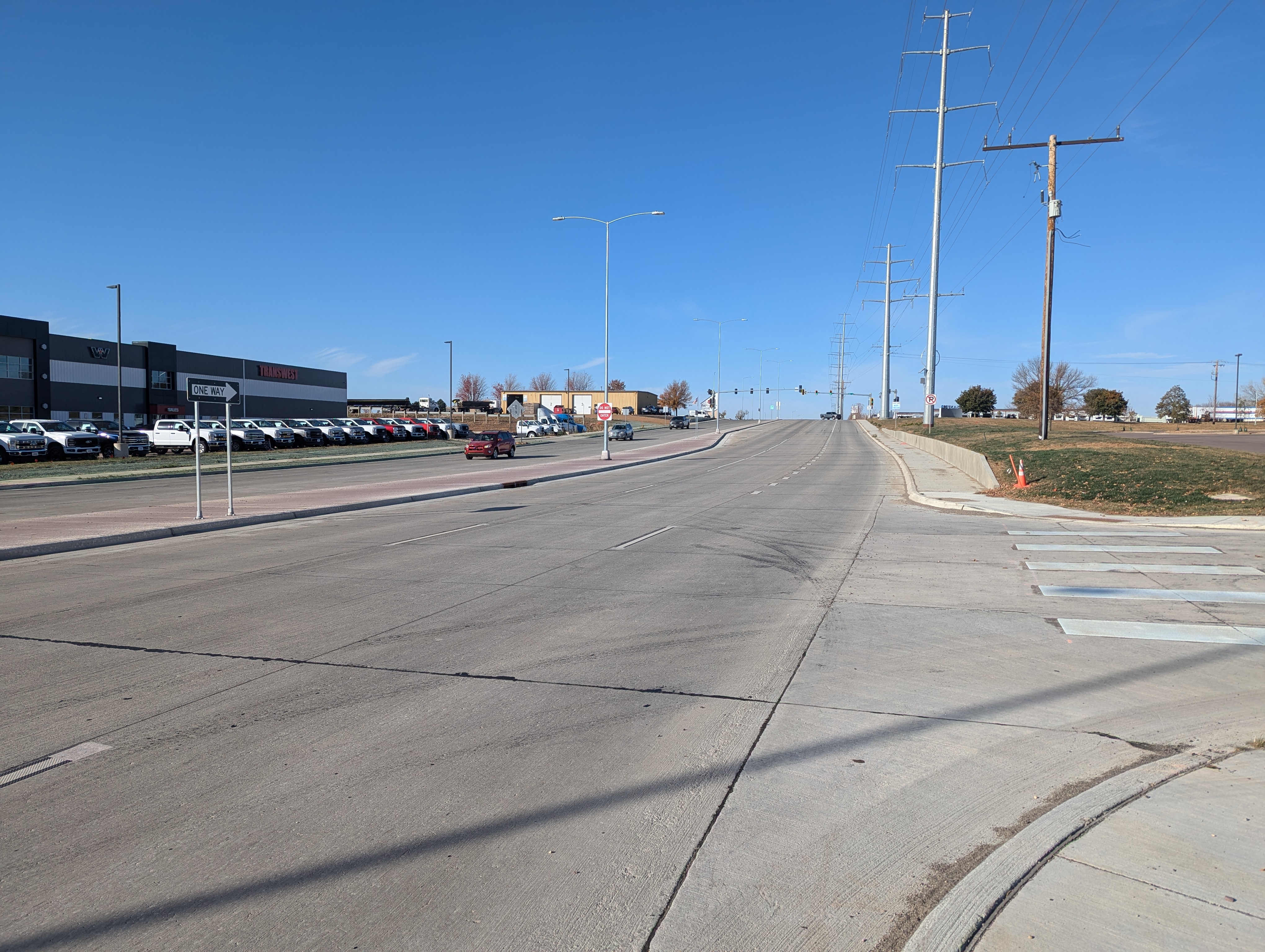

  • The southbound on-ramp from Benson Road to I-229 will reopen during the first week in July, weather permitting.
  • The mainline paving of Benson Road between Lewis Avenue and Potsdam Avenue began in late June, and will be completed in early July, weather permitting. Median paving and sidewalks will follow later this summer.
  • Lewis Avenue is expected to be paved in the next few weeks, weather permitting.
  • Bridge decking repairs are almost complete.

Commuter Route Information:

  • Traffic is reduced to one lane in each direction.

Project Milestones

Year 2023

  1. Bridge work
  2. Pavement removals
  3. Watermain installation
  4. Sanitary sewer repairs & installation
  5. Storm drainage improvements
  6. Grading
  7. Gravelling
  8. Concrete Paving
  9. Driveways, approaches, curb ramp, and sidewalk construction
  10. End bridge work
  11. Restoration

Year 2024  Phase 1

  1. Bridge deck work
  2. Pavement removals
  3. Watermain installation
  4. Sanitary sewer repairs & installation
  5. Storm drainage improvements
  6. Grading
  7. Gravelling
  8. End bridge deck work
  9. Concrete Paving
  10. Driveways, approaches, curb ramp, and sidewalk construction
  11. Restoration

Year 2024 – Phase 2 (median)

  1. Grading
  2. Graveling
  3. Concrete Paving

Year 2024 – Phase 3 (interchange islands)

  1. Grading
  2. Gravelling
  3. Concrete Paving
