Arrowhead Parkway and Veterans Parkway Intersection Phase 2B

  • Project value$39,231,240.02
  • Contractor nameT&R Contracting, inc.
  • Completion DateMay 14, 2027

Project Update: 10/31/2025

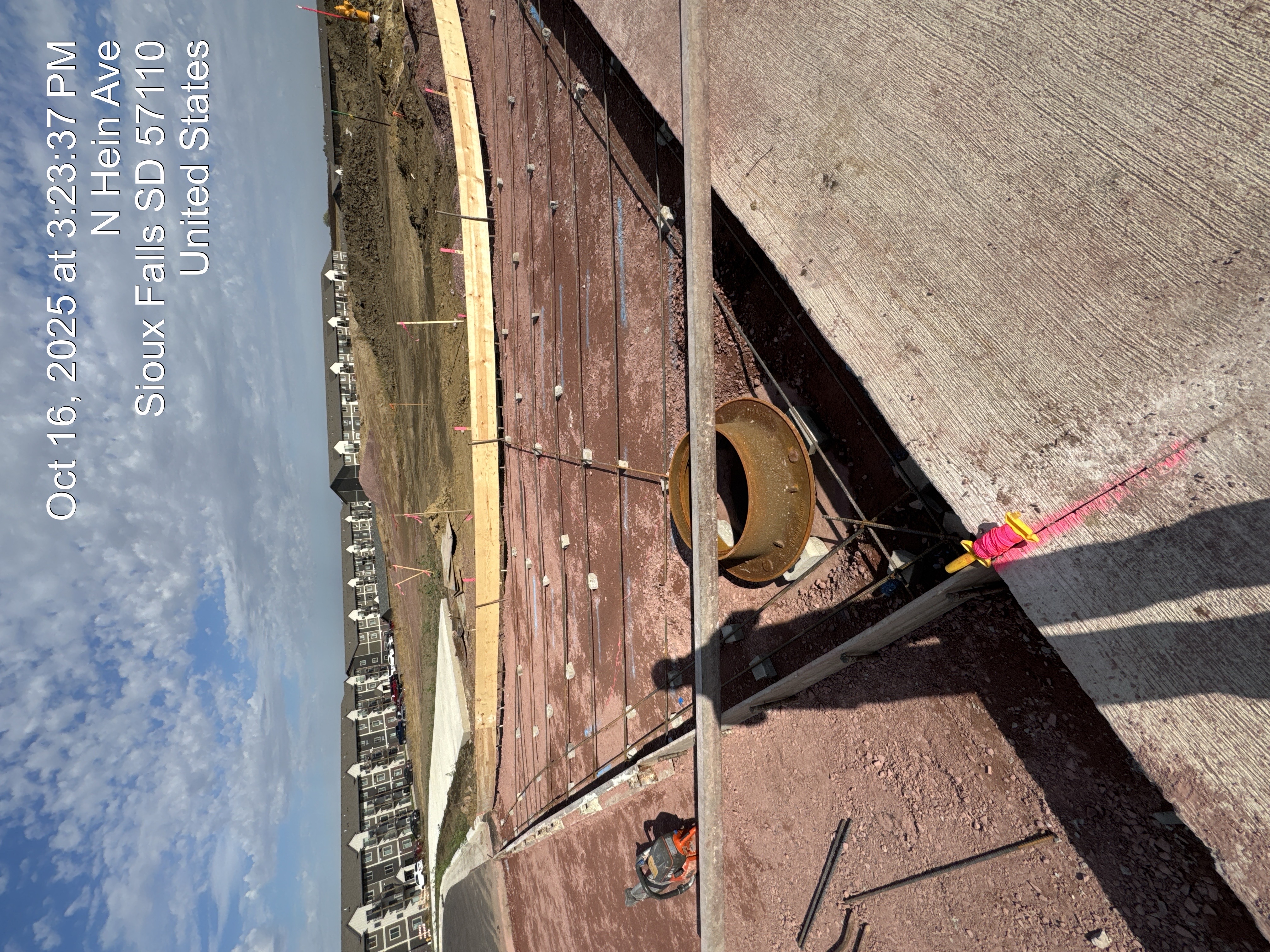

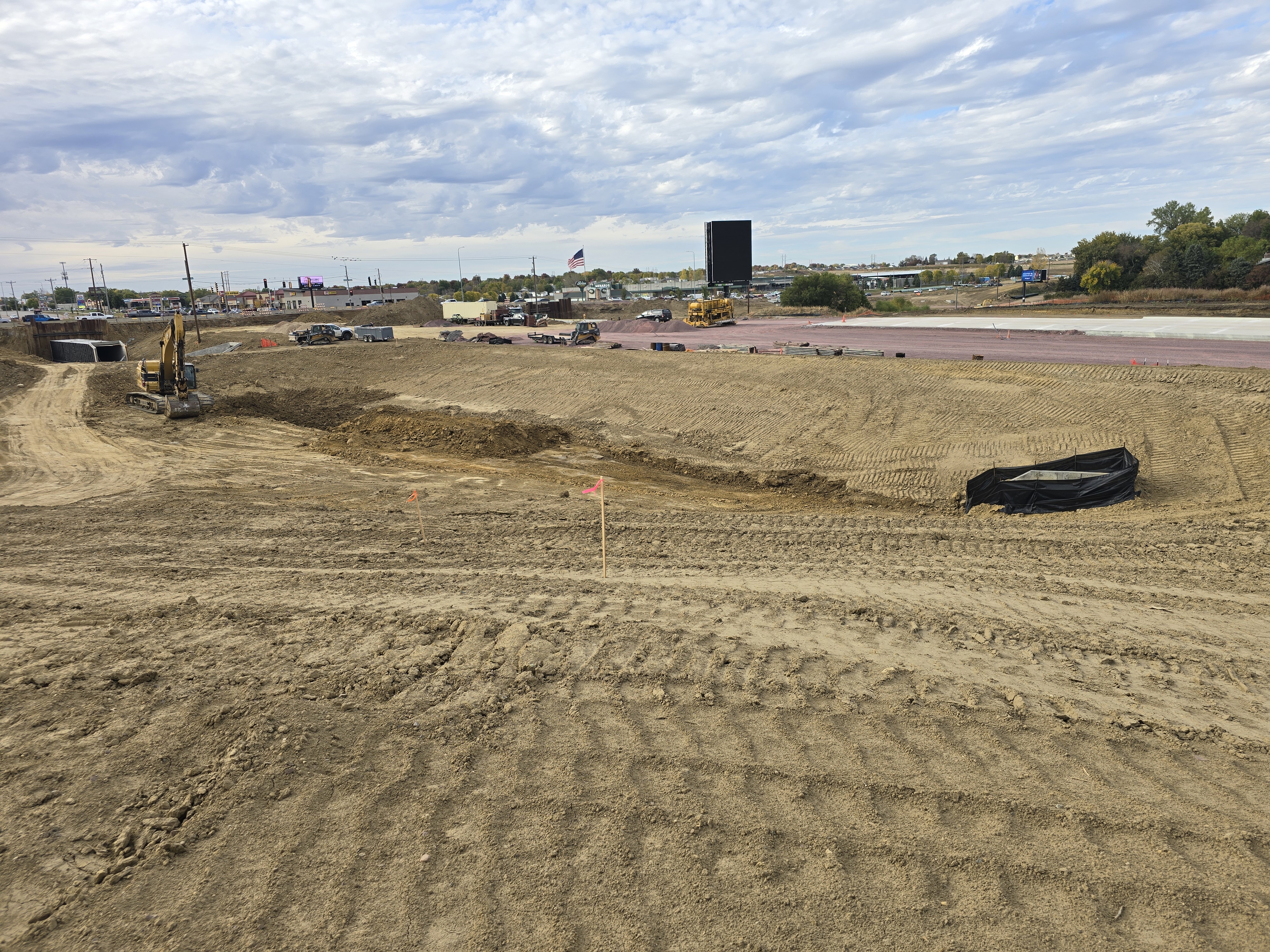

The contractor has completed concrete paving along Arrowhead Parkway from 10th Street to just east of Veterans Parkway and has reconstructed the Arrowhead service road.  They have also been working on the final grading along Arrowhead and Veterans Parkway in preparation for the winter months. Final restoration will occur in the spring of 2026.

The contractor is currently working on installing the asphalt roadway transition from Veterans Parkway east to the new concrete pavement on Arrowhead Parkway.  They are also continuing to work on installing asphalt pavement for the bike trails along Veterans Parkway

Commuter Route Information

2025

  • Arrowhead Parkway will be closed east of Veterans Parkway for the duration of the 2025 construction season.

2026

  • Arrowhead Parkway will close east of Veterans Parkway for about 5-6 weeks, first thing in the spring, to remove the temporary asphalt transition, construct the east lanes of Veterans Parkway, and connect to Arrowhead Parkway going east
  • After the work east of Veterans is complete and reopened to traffic, Arrowhead Parkway will close west of Veterans Parkway and remain closed for the duration of the 2026 construction season
  • Veterans Parkway will remain open to one lane of traffic in each direction throughout the 2026 construction season

2027

  • Periodic lane closures may occur in the spring of 2027 as work is finalized and general site cleanup occurs.

Phase 1 Detour Map

Veterans Parkway and Arrowhead Detour Map Image

2026

  • Arrowhead Parkway will be closed west of Veterans Parkway for the duration of the 2026 construction season.
  • Arrowhead Parkway east of Veterans Parkway will remain open to one lane of traffic in each direction at all times during 2026.
  • Veterans Parkway will remain open to one lane of traffic in each direction at all times during 2026.

2027

  • Periodic lane closures may occur in the spring of 2027 as work is finalized and general site cleanup occurs.

Project Milestones

2025

  1. Temporary traffic signals/traffic control
  2. Removals
  3. Rough Grading
  4. Resurface existing Highway 42 for frontage road
  5. Water main - 6th Street to Staudenmier Place
  6. Sanitary Sewer
  7. Casing pipe for the force main through the intersection
  8. Force main - Arrowhead Parkway to 6th Street
  9. Force main - Arrowhead Parkway to 26th Street
  10. Water main
  11. Pedestrian underpasses
  12. Storm drainage piping and structures
  13. Retaining walls
  14. Finish grading
  15. Gravel base preparation/installation
  16. Concrete paving - westbound lanes, 10th to Hein Avenue
  17. Concrete paving - westbound lanes, Hein Avenue to Veterans Parkway
  18. Temporary Transition - Arrowhead Parkway

2026

  1. Traffic control
  2. Removals
  3. Casing pipe for the force main through the intersection
  4. Water main - Arrowhead Parkway to Staudenmeier Place
  5. Water main - Arrowhead Parkway to 26th Street
  6. Storm drainage piping and structures
  7. Retaining walls
  8. Pedestrian underpasses
  9. Finish gradng
  10. Gravel base preparation/installation
  11. Concrete paving - eastbound lanes, Veterans Parkway to 10th Street
  12. Concrete paving - eastbound lanes, Veterans Parkway to Highline Avenue
  13. Concrete paving - westbound lanes, Veterans Parkway to Highline Avenue
  14. Concrete paving - southbound lane, Veterans Parkway
  15. Concrete paving - northbound lanes, Veterans Parkway
  16. Sidewalks
  17. Medians
  18. Street Lighting
  19. Traffic Signals
  20. Signage
  21. Pavement Markings
  22. Site Restoration
