20th Street from 7th Avenue to Cliff Avenue Reconstruction

  • Project value$1,775,000.00
  • Contractor nameT&R Contracting, inc.
  • Completion DateNovember 06, 2026
20th Street Construction Banner

(See the above image in a new window)

Project Update: 08/31/2026

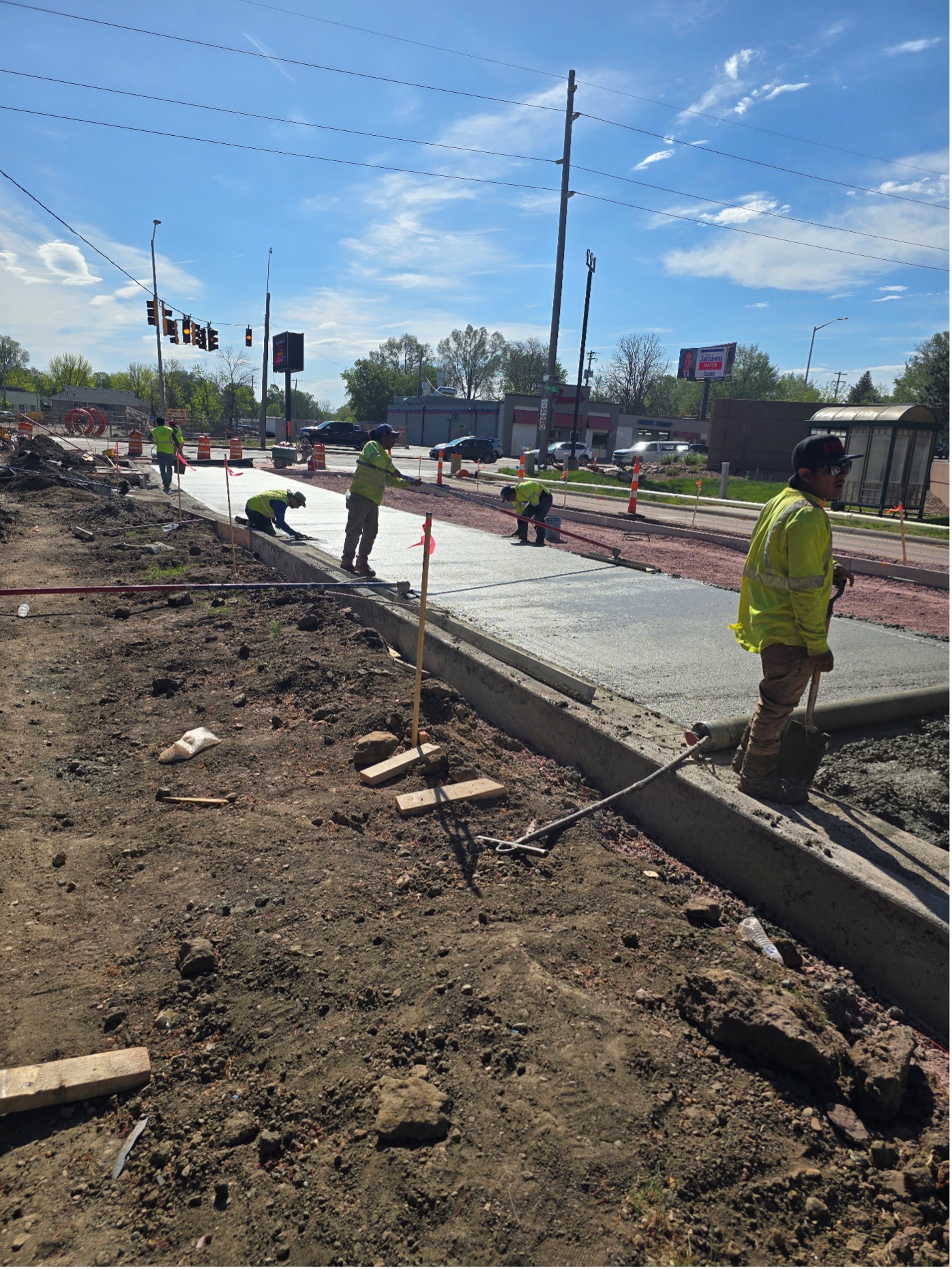

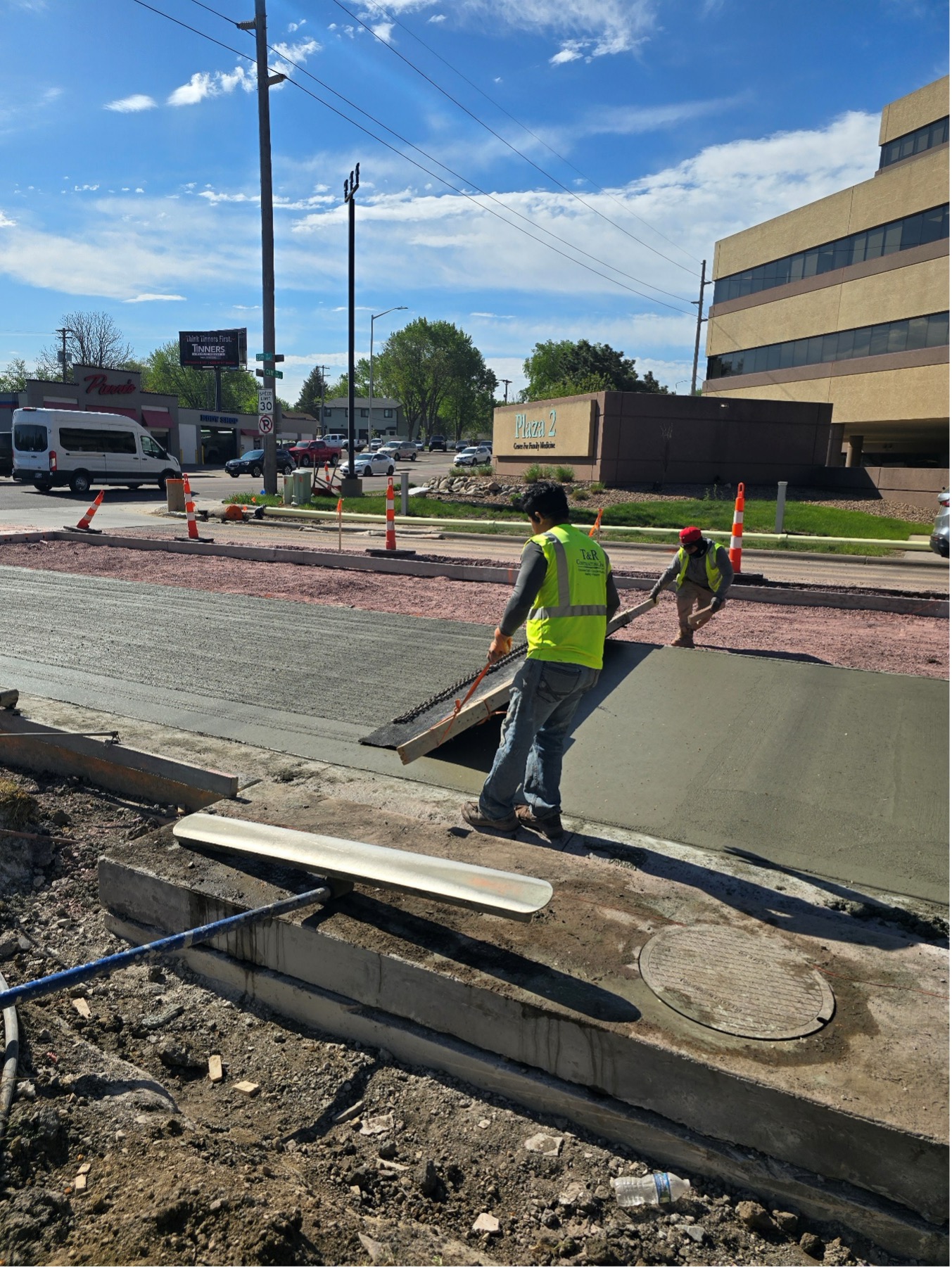

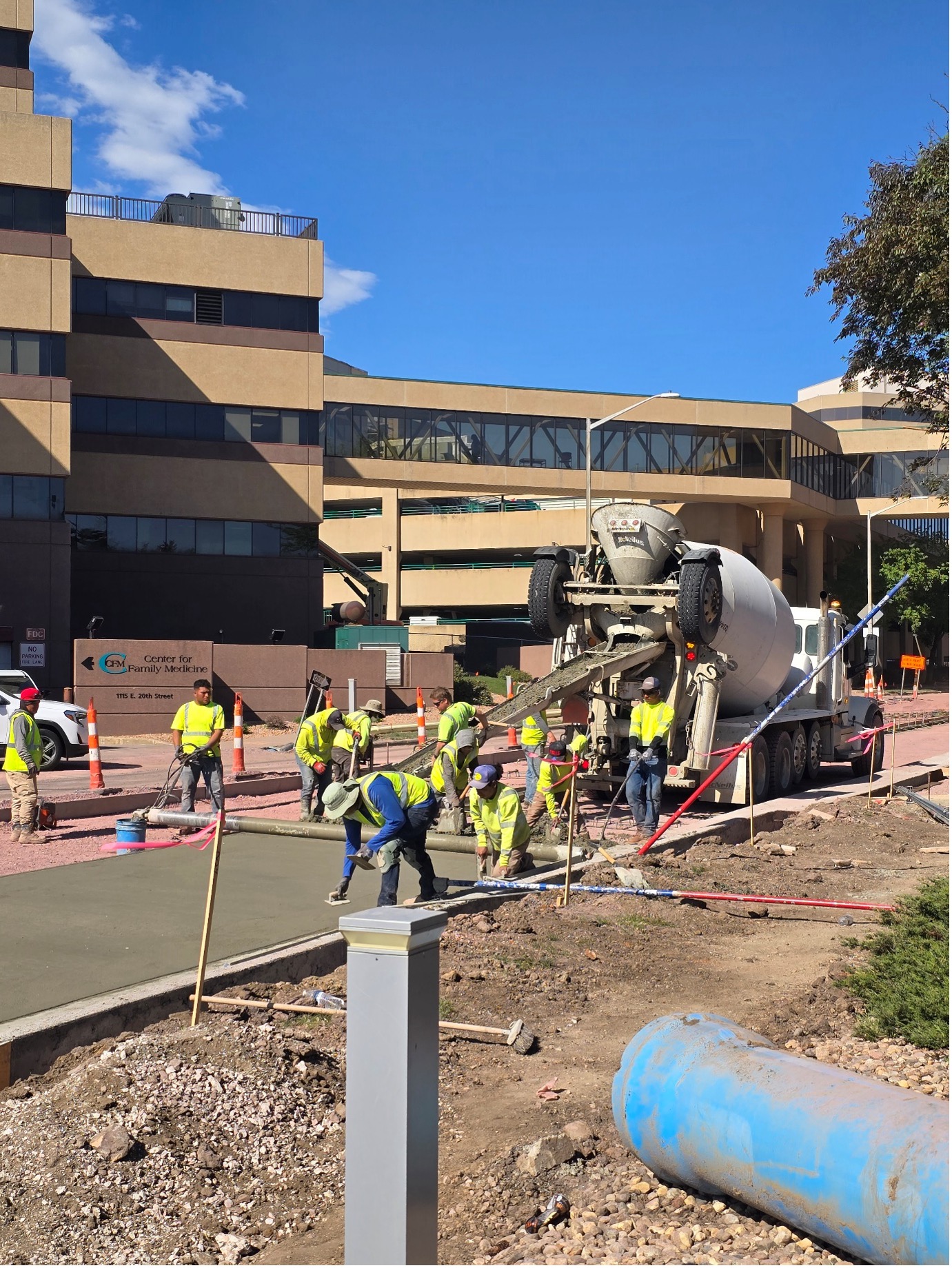

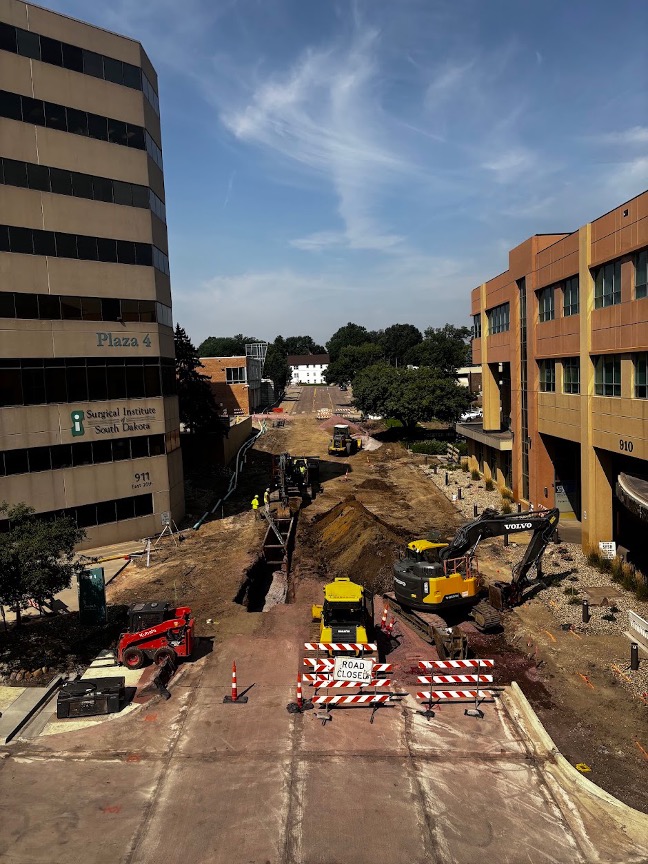

Phase 4 utility installation is complete; grading is underway. Phase 4 concrete paving begins Monday, August 31st.

Phase 5 is expected to begin September 14th and is the final phase for this project.

Phase 5 closes 20th Street between 7th Avenue and 8th Avenue.

Access During Phase 5

  • Access to Avera McGreevy will need to come from 7th Avenue.
  • Access for SFSH and Avera Plaza 2 and Plaza 4 will need to come from Cliff Avenue.
  • Deliveries to the Avera loading docks will need to come from Cliff Avenue.

Completion of the project is expected mid-November.

Emergency Services Access:
Emergency responders are advised to access the Avera Emergency Room from 7th Avenue for the duration of this phase of construction. Motorists are strongly encouraged to utilize 17th Street or 26th Street to access 7th Avenue.

Pedestrian Access:
Pedestrian routes will be signed, and Audible Information Devices (AIDs) will be provided to assist those navigating the detour.

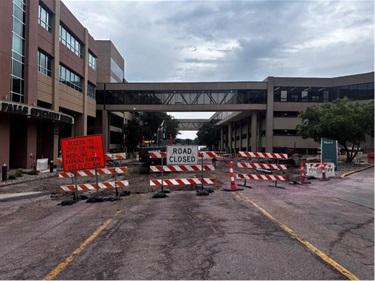

Phase 4 traffic control

Commuter Route Information

  • Currently, 20th Street is closed from 8th Avenue to 9th Avenue.

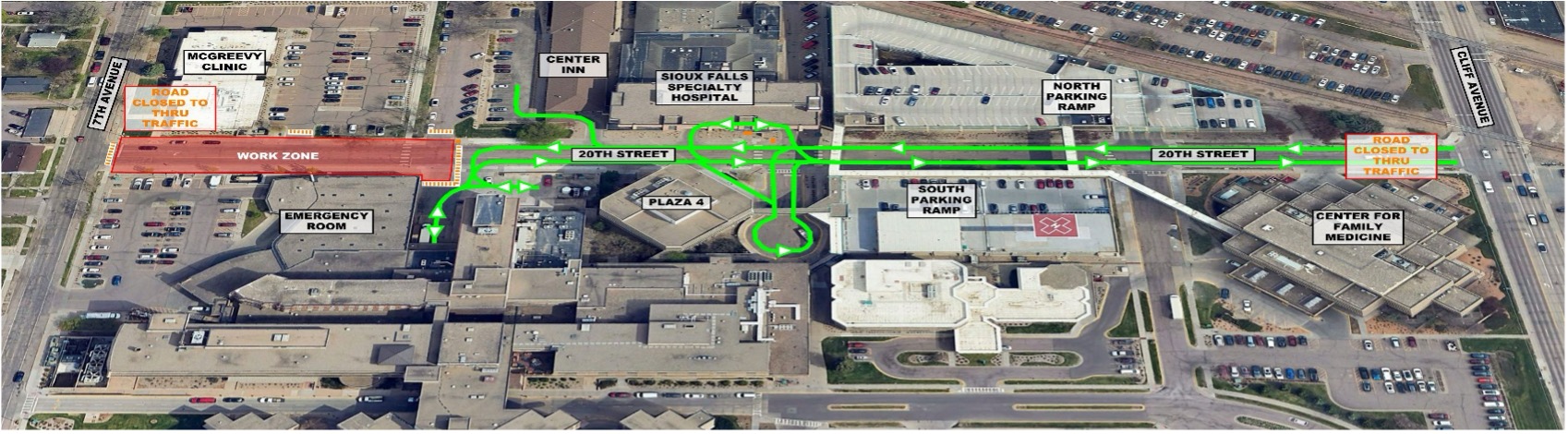

  • Beginning September 14th, traffic will be closed on 20th Street from 7th Avenue to 8th Avenue
  • 2 way traffic on 20th Street is OPEN for parking ramp access, Center for Family Medicine, SFSH, and Avera Plaza 4 – access from Cliff Avenue
  • Access to Avera Loading Dock will come from Cliff Avenue for the final phase of the project
  • Access to Avera McGreevy will come from Cliff Avenue for the final phase of the project

Project Phasing Diagram

20th Street Construction Phases

Project Milestones

Phase 1 – North half of 20th Street from Cliff to 9th Avenue

  1. Removals
  2. Watermain
  3. Grading
  4. Gravel base preparation and installation
  5. Concrete Paving
  6. Restoration

Phase 2 – South half of 20th Street from Cliff to 9th Avenue

  1. Removals
  2. Sanitary Sewer
  3. Watermain
  4. Street Lighting
  5. Grading
  6. Gravel base preparation and installation
  7. Concrete Paving
  8. Restoration

Phase 3 – 9th Avenue / SFSH Entrance Intersection

  1. Removals
  2. Sanitary Sewer
  3. Watermain
  4. Street Lighting
  5. Grading
  6. Gravel base preparation and installation
  7. Concrete Paving
  8. Restoration

Phase 4 – SFSH Exit and Avera Loading Dock Entrance

  1. Removals

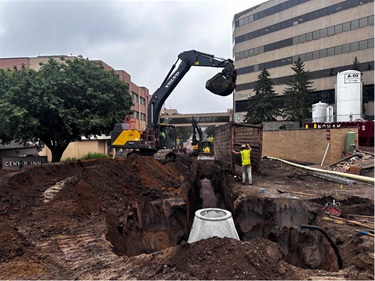

  2. Sanitary Sewer
  3. Watermain

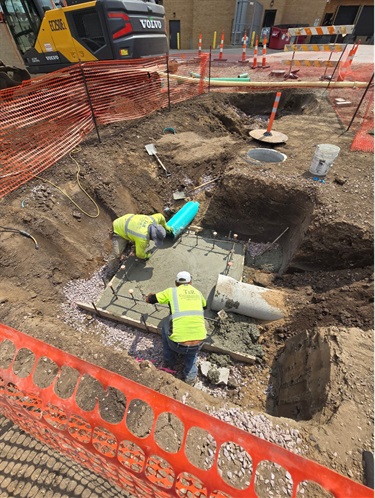

  4. Storm Drainage
  5. Street Lighting
  6. Grading
  7. Gravel base preparation and installation
  8. Concrete Paving
  9. Restoration

Phase 5 – Avera Loading Dock Entrance to 7th Avenue

  1. Removals
  2. Watermain
  3. Storm Drainage
  4. Street Lighting
  5. Grading
  6. Gravel base preparation and installation
  7. Concrete Paving
  8. Asphalt Paving
  9. Restoration

General

  1. Pavement Markings
  2. Traffic Signage

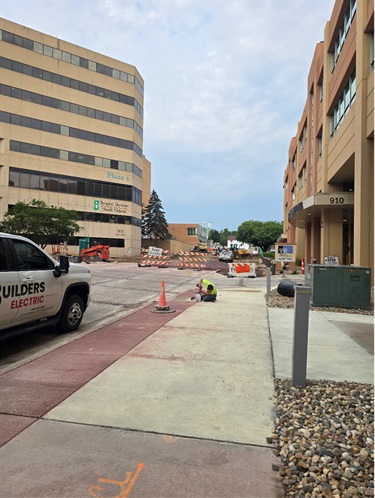

  3. Pedestrian Crossing Equipment

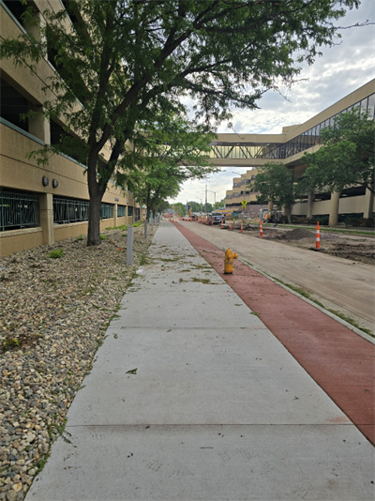

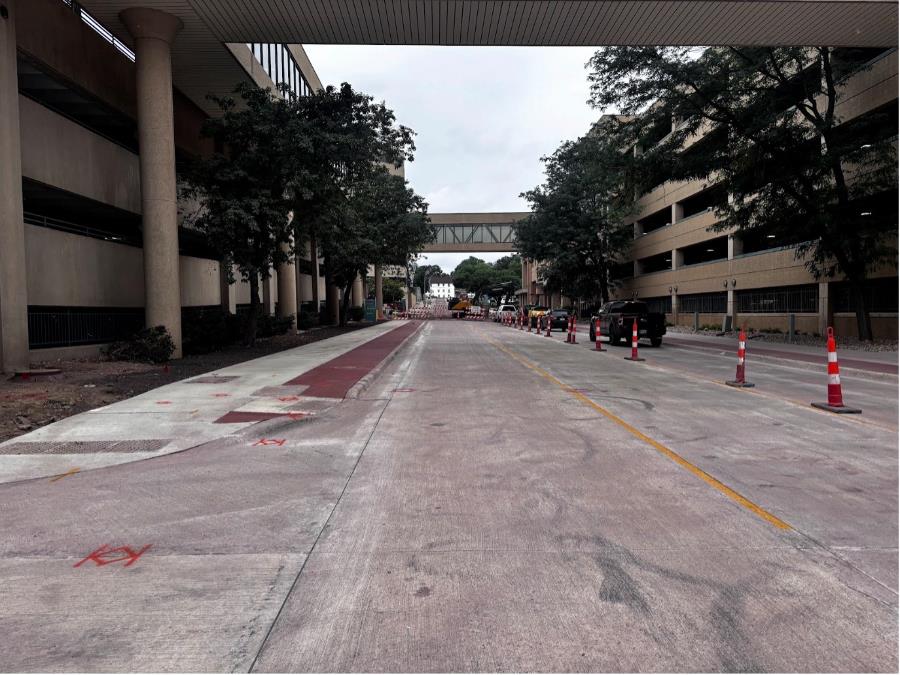

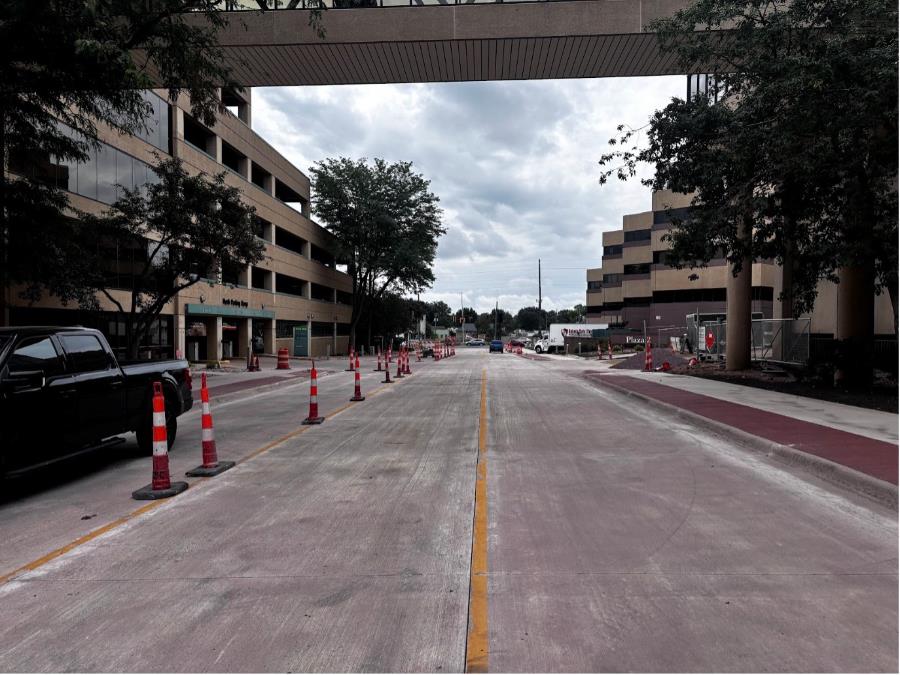

Construction Images
