Minnesota Avenue from 2nd Street to 8th Street Reconstruction

  • Project value$12,241,812.80
  • Contractor nameD&G Concrete Construction, Inc.
  • Completion DateJune 25, 2027
Rendering of Minnesota Avenue Phase 2 improvements

Project Update: 11/02/2026

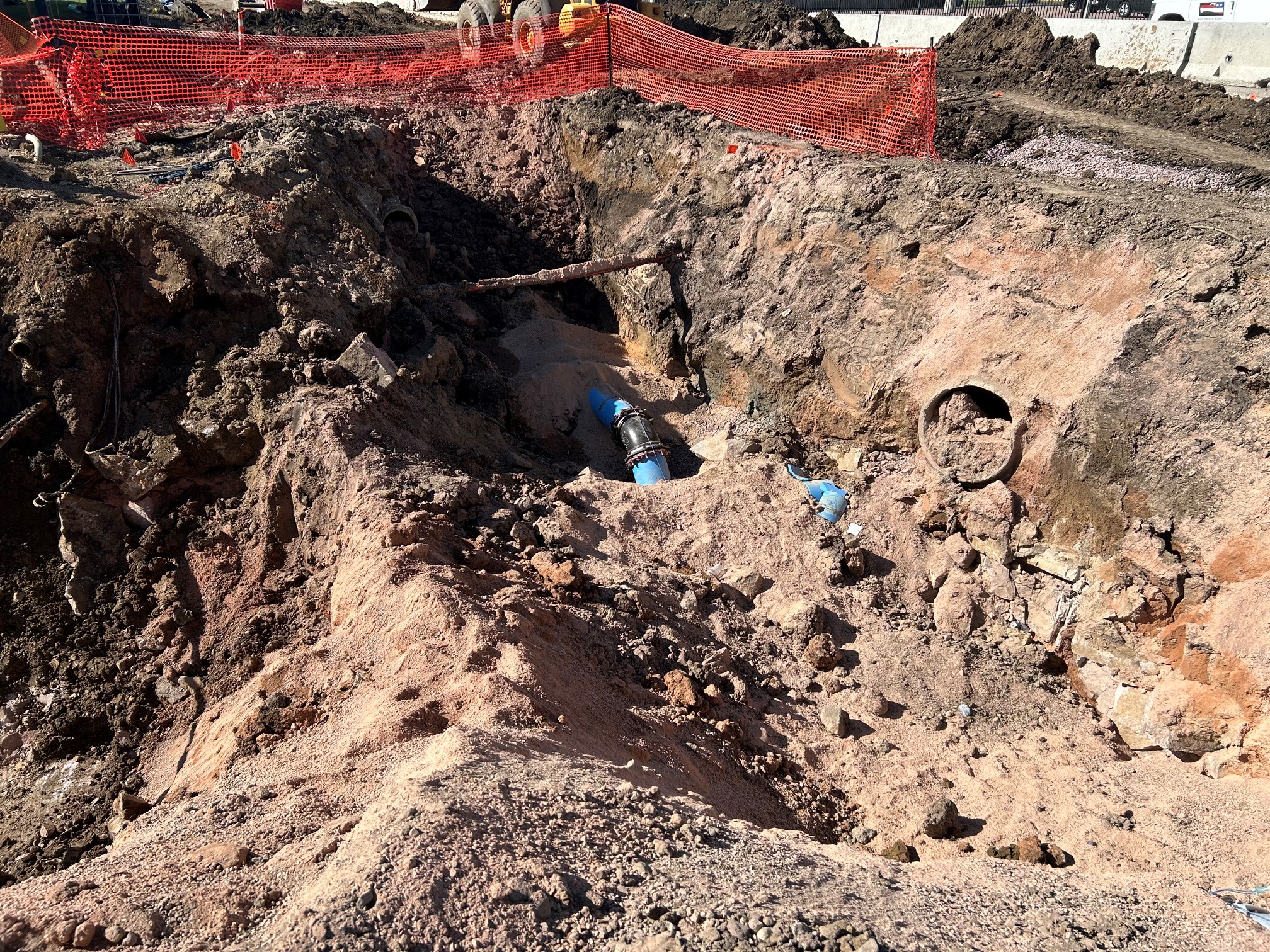

  • The contractor is currently working on the 42-inch water main and storm sewer crossings on the west side of Minnesota Ave between 4th and 8th Street..

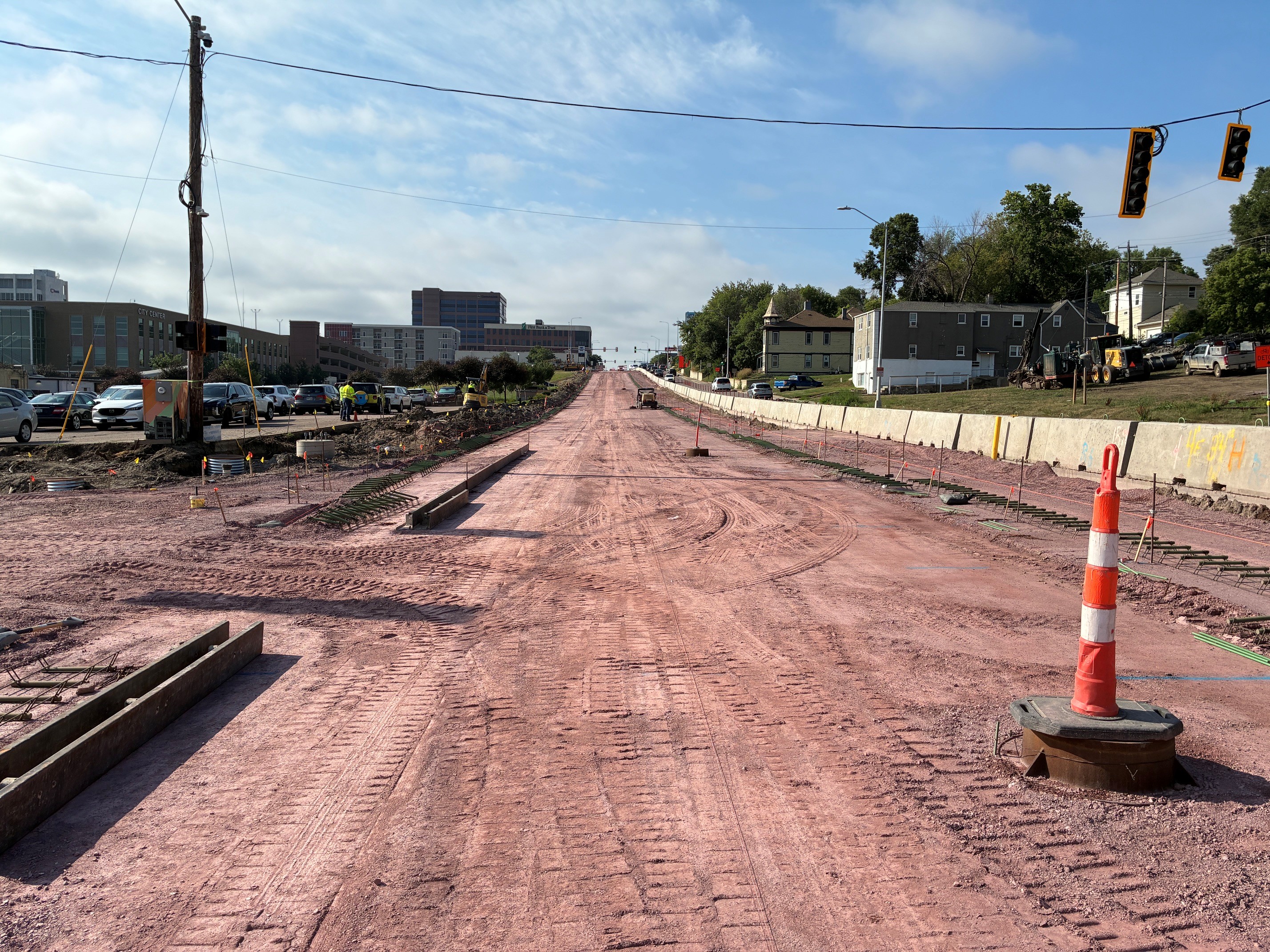

  • The contractor is also working on roadway grading between 4th and 6th Street. After the road is at grade, the contractor will cement-stabilize the subgrade, with road base and concrete paving to follow.

Commuter Route Information

  • Traffic is reduced to one lane in each direction along Minnesota Avenue from 2nd Street to 8th Street. Access to side streets within the construction zone will be limited.
  • Please follow the project detours. Eastbound and westbound left turns will be restricted due to the single-lane traffic.  Pedestrian detours will be established to allow crossings at 8th Street and Brookings Street.

Minnesota Ave Phasing Plan image

Project Milestones

Phase 1A – 2nd Street to 4th Street (center utilities and east side of Minnesota Ave)

  1. Temporary Traffic Signals at the intersections of 2nd Street and 6th Street.
  2. Install traffic control
  3. Install erosion control
  4. Removals
  5. 12" Water main
  6. Sanitary sewer
  7. Storm drainage
  8. Traffic conduit
  9. Grading & gravel
  10. Concrete pavement
  11. Sidewalk
  12. Restoration

Phase 2A – 2nd Street to 4th Street (west side of Minnesota Ave)

  1. Install traffic control
  2. Install erosion control
  3. 42" Water main
  4. 8" Water main
  5. Storm drainage
  6. Traffic conduit
  7. Grading & gravel
  8. Concrete pavement
  9. Sidewalk
  10. Restoration

Phase 1B – 4th Street to 8th Street (center utilities and east side of Minnesota Ave)

  1. Temporary Traffic Signals at the intersections of 2nd Street and 6th Street.
  2. Install traffic control
  3. Install erosion control
  4. Removals
  5. 12" Water main
  6. Sanitary sewer
  7. Storm drainage
  8. traffic conduit
  9. Grading & gravel
  10. Concrete pavement
  11. Sidewalk
  12. Restoration

Phase 2B – 4th Street to 8th Street (west side of Minnesota Ave)

  1. Install traffic control
  2. Install erosion control
  3. 42" Water main
  4. 8" Water main
  5. Storm drainage
  6. Traffic conduit
  7. Grading & gravel
  8. Concrete pavement
  9. Sidewalk
  10. Restoration

Phase 3A – (Remove, salvage, replace median from 2nd St to Bennett St)

  1. Install traffic control
  2. Remove and salvage the existing low-profile median
  3. Install proposed median pavement within the phase limits

Phase 3 – (median of Minnesota Ave)

  1. Install traffic control
  2. Concrete pavement
