Arrowhead Parkway and Veterans Parkway Improvements
- Project value$39,231,240.02
- Contractor nameT&R Contracting, inc.
- Completion DateMay 14, 2027
Project Update: 03/18/2026
As winter is nearing its end, construction along the Veterans and Arrowhead Parkway corridor will begin soon.
The contractor will begin with roadway grading for the northbound lanes of Veterans Parkway prior to the closing of Arrowhead Parkway east of Veterans Parkway. The closure along Arrowhead Parkway east of Veterans Parkway will remove the temporary asphalt section that was placed last fall and replace it with new concrete pavement. Once this work is completed, the east side of the intersection, including the northbound lanes of Veterans Parkway, will be open to traffic.
When the east side of the intersection opens, the west side of the intersection will be closed. This will allow the contractor to finish the work on this side, with all lanes open to traffic at the end of the 2026 construction season.
Commuter Route Information
2026
- Arrowhead Parkway will close east of Veterans Parkway for about 5-6 weeks, first thing in the spring, to remove the temporary asphalt transition, construct the east lanes of Veterans Parkway, and connect to Arrowhead Parkway going east
- After the work east of Veterans is complete and reopened to traffic, Arrowhead Parkway will close west of Veterans Parkway and remain closed for the duration of the 2026 construction season
- Veterans Parkway will remain open to one lane of traffic in each direction throughout the 2026 construction season
2027
- Periodic lane closures may occur in the spring of 2027 as work is finalized and general site cleanup occurs.
Project Milestones
2025
- Temporary traffic signals/traffic control
- Removals
- Rough Grading
- Resurface existing Highway 42 for frontage road
- Water main - 6th Street to Staudenmier Place
- Sanitary Sewer
- Casing pipe for the force main through the intersection
- Force main - Arrowhead Parkway to 6th Street
- Force main - Arrowhead Parkway to 26th Street
- Water main
- Pedestrian underpasses

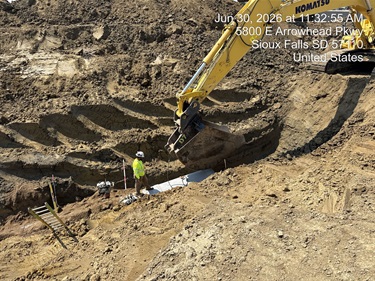

- Storm drainage piping and structures
- Retaining walls
- Finish grading
- Gravel base preparation/installation
- Concrete paving - westbound lanes, 10th to Hein Avenue
- Concrete paving - westbound lanes, Hein Avenue to Veterans Parkway
- Temporary Transition - Arrowhead Parkway
2026
- Traffic control
- Removals
- Casing pipe for the force main through the intersection
- Water main - Arrowhead Parkway to Staudenmeier Place
- Water main - Arrowhead Parkway to 26th Street
- Storm drainage piping and structures
- Retaining walls
- Pedestrian underpasses
- Finish gradng
- Gravel base preparation/installation
- Concrete paving - eastbound lanes, Veterans Parkway to 10th Street
- Concrete paving - eastbound lanes, Veterans Parkway to Highline Avenue
- Concrete paving - westbound lanes, Veterans Parkway to Highline Avenue
- Concrete paving - southbound lane, Veterans Parkway
- Concrete paving - northbound lanes, Veterans Parkway
- Sidewalks
- Medians
- Street Lighting
- Traffic Signals
- Signage
- Pavement Markings
- Site Restoration
